Engineering Case study

Workspace v2 tab system performance: first load, hot switch, and background pressure

A performance write-up about separating first load, hot tab switch, background pressure, and the gates that kept false wins out.

Published 8 min read 中文版

Background and goals

After the tab system landed, Workspace no longer had one foreground page. Users can keep multiple workstreams, subapps, and objects open. The host may keep more routes, runtimes, iframes, SDKs, and background tasks alive too. Performance moved from a single-page FMP problem into a resource ownership problem across the shell, subapps, and retained runtimes.

Users only care whether the focused tab becomes visible, usable, and stable. Behind that tab, hidden runtimes, prewarm jobs, subapp SDKs, iframes, analytics, and monitoring tasks may still be alive. A cleaner waterfall is not enough. Three user paths have to be protected separately.

workspace tab system demo
Figure 0: A generic workbench using browser-like tabs. The performance problem starts because multiple work items can stay open, while only the focused tab should stay interactive and own foreground resources.
PathProblemMetric And Acceptance Standard
First Load / FMPWhen users enter Workspace or a subapp for the first time, they only need the current page, but network and main-thread budget may be spent on future paths, non-current subapps, or low-priority SDKs.route FMP, critical-resource waterfall, first-screen APIs. A win must show a blocker moving earlier, disappearing, or shrinking, and final FMP must improve.
Hot Tab SwitchWhen users click an already-open tab, the frame may be visible but still not clickable, or visible work may be blocked by long tasks.tab switch v3, post-visible blocking, long task. Shell-visible alone is not enough.
Background PressureHidden tabs, prewarm jobs, SDKs, WebSocket, analytics, and monitoring tasks may steal main-thread time while the user switches tabs.long task, frame gap, foreground lease, local stress gate. Background work must yield to the foreground tab.

Business goals and technical constraints:

GoalEngineering Constraint
Users can keep multiple workstreams, subapps, and objects open.First load, hot switch, and background tasks must not become obviously slower because more runtimes exist.
Tab switching should feel close to a browser.We cannot reload every tab to save memory, and we cannot keep every runtime alive to make switching fast.
Refresh, sharing, multiple windows, and subapp SDK behavior must remain correct.Performance work must not break tab state recovery, business URLs, cross-window sync, or subapp open intent.
Performance claims must be credible.preview FMP, strict tab switch, and local stress gates must be measured separately.

Optimization principle:

First identify the user path. Then decide whether a resource should start earlier, move later, stay warm, or be cancelled. Every accepted win must show the blocker moving, disappearing, shrinking, or moving after the visible path.

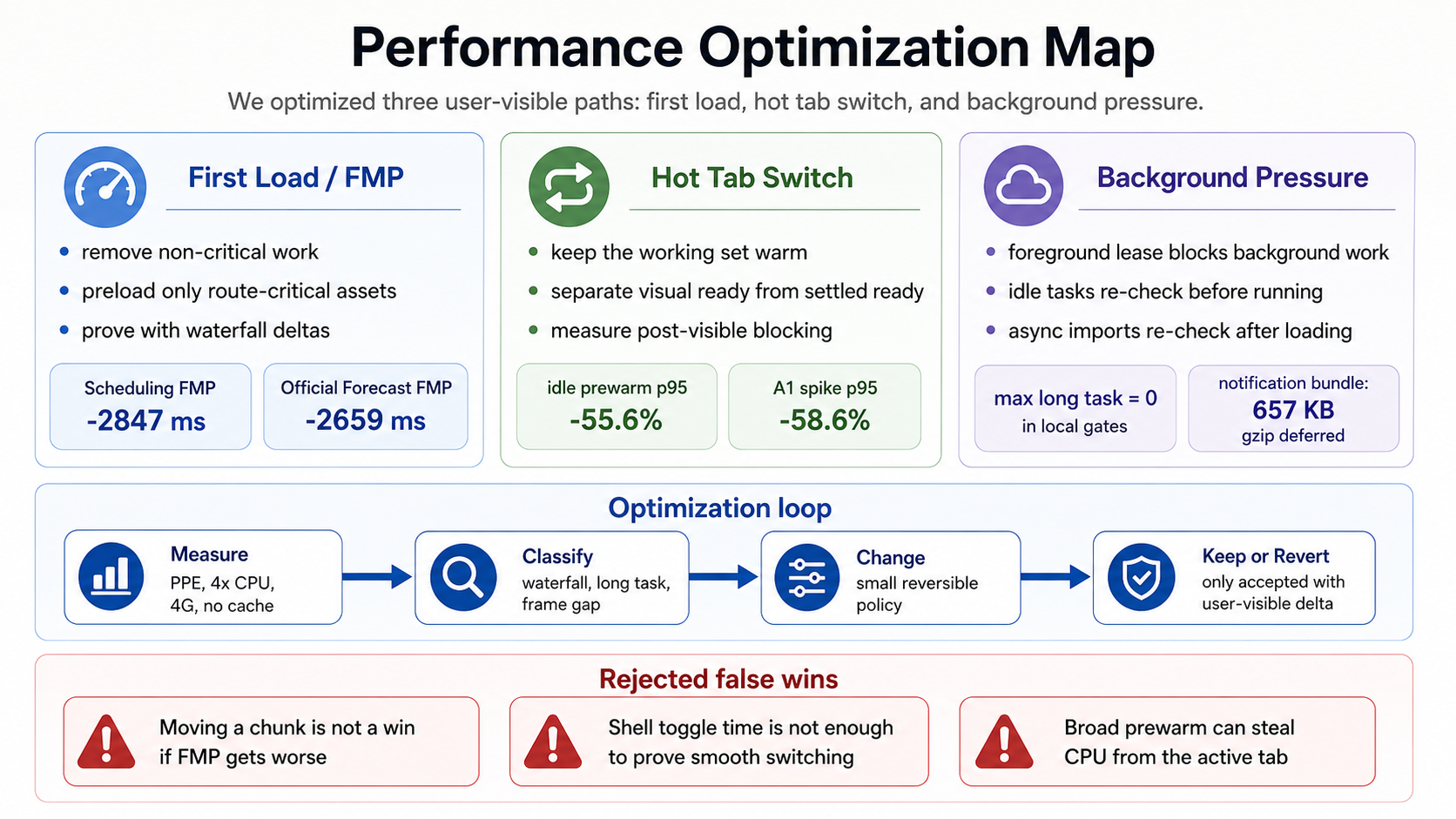

performance map
Figure P1: Performance optimization map. The map separates first-screen critical path, hot tab switch, and background pressure, and also lists false wins that were rejected.

Product-scale baseline and result shape

The product-level target was roughly 1s P90 for the Workspace shell and 2.5s P90 for subapps running on Workspace. The early baseline missed that target across the main modules. Some paths were far beyond the budget.

The table below is a weekly field-report view. It shows scale and trend. It is not the same measurement as the strict preview profiles used later for individual changes.

ModuleEarly Weekly FMPLater Weekly FMPTargetTrend
Workspace shell2049ms1718ms1000ms-16.2%
Report Center6996.95ms2741ms2500ms-60.8%
Scheduling8313ms2342ms2500ms-71.8%
Omni Workbench3186.9ms2485ms2500ms-22.0%
Field Management4054.56ms3613ms2500ms-10.9%

This table is not a claim that every problem was solved. That is the point. Some modules reached or approached the target; others still needed bottleneck work. The strict profiles below are responsible only for the specific changes they measure, and the article keeps that boundary explicit.

That is also why the rest of this article is organized by engineering problem instead of commit history: problem scale, metric definition, resource ownership, rejected alternatives, and the proof used to accept each change.

Results

AreaProblemBeforeAfterDeltaEvidence
SchedulingRoute chunks were discovered too late and overlapped the final FMP window.route FMP 14773ms11926ms-2847ms / -19.3%strict preview waterfall; route chunks changed from late discovery to route-aware preload
Official ForecastRoute-critical CSS was discovered near the end of the path.route FMP 14271ms11612ms-2659ms / -18.6%strict preview waterfall; CSS moved from around 13.8s to around 1.9s
Workspace FMP cleanupHost uploader started before FMP on every measured main route.pre-FMP count 7/7 routes0/7 routesmain run improved on 6/7 paths, average about -1037msstrict FMP loop; cleanup pattern evidence
Sandbox entry fanoutNon-current sandbox entry competed with the current route.affected routes 50average about -366ms vs previous accepted runstrict FMP loop; non-current sandbox entry moved after FMP
Cold tab switchThe target runtime and view were loaded only after click.p95 duration 1829.8ms812.3ms-55.6%strict tab-switch probe; idle prewarm
Cold tab switchFrame was visible, but users were still blocked.p95 post-visible blocking 1193.7ms8.7ms-99.3%strict tab-switch probe; blocking moved from after click to before click
Spike controlHidden prewarm and background SDK work stole foreground CPU.A1 p95 duration 1700.1ms703.1ms-58.6%strict tab-switch probe; hidden prewarm paused during switch
Background pressureBackground SDKs could become future tab-switch jank sources.max long task present riskmax post-visible long task = 0guardrail, not preview-environment main winlocal stress gate; Notification/WebSocket/analytics/monitoring moved into scheduler

Two guardrails:

  1. Strict preview FMP, strict tab switch, and the local stress gate are not combined into one total number.
  2. Moving resources is not a win by itself. We only keep a change when the user metric improves and the diagram explains why.

Measurement contract

Strict FMP comparisons used the same setup:

  • authenticated preview environment;
  • target preview-environment headers;
  • browser cache disabled;
  • CPU 4x throttle;
  • 4G network throttle;
  • same route set and same final FMP marker semantics;
  • failed experiments kept in the record and excluded from wins.

Tab switch uses v3 metrics instead of only “how long after click until the frame appears.”

v3 FieldMeaning
inputDelayMsFrom user input to React handler start; captures main-thread queueing.
shellVisibleMsFrom handler start to focused hot frame visible.
interactiveReadyMsTarget tab can respond to interaction.
postVisibleBlockingMsTime after frame is visible while the user is still blocked.
postVisibleJankMsFrame gap / long task after visibility.
settledReadyMsTime to a 500ms quiet window; compatible with old duration but with clearer semantics.

The most important measurement repair was separating visible from interactive. Old metrics could report tens of milliseconds while strict probe still found hundreds or thousands of milliseconds of post-visible long task. After this repair, only changes that reduce post-visible blocking or final FMP are accepted.

Measurement and gates

These wins did not come from one manual run. We split validation into three harnesses, each answering one question.

HarnessHow It RunsWhat It CapturesWhat It Accepts Or Rejects
Strict preview FMP profilerAuthenticated CDP Chrome; target preview route; target preview-environment headers; cache disabled; CPU 4x; 4G; every run starts from clean root-tab; 30s captureroute FMP, subapp load-start, critical-resource waterfall, pre-FMP resource countA route win must improve previous/current delta for the same marker and have a waterfall explanation. Cleaner resource counts with worse FMP are rejected.
Strict tab-switch probeCDP drives real tab activation; samples cover Workstream native, Workstream sandbox/Supervisor, and other opened tabs; v3 starts from real input timestamp and waits for visible stable frame / quiet windowinputDelayMs, shellVisibleMs, interactiveReadyMs, postVisibleBlockingMs, postVisibleJankMs, frame gap, long taskFrame visible alone is not accepted. p95/max, post-visible blocking, and worst samples must improve across repeated strict profiles.
Local stress gateWorkspace tab-switch stress spec; mocked backend + real browser; 20 opened tabs, 5 hot workstream caches, overlay containment, background SDK/prewarm taskshot switch summary, post-visible blocking, long task, warm-pool count, cache miss, overlay hit-testRegression gate, not preview-environment main win. It requires no new post-visible long task, bounded warm pool, and no hidden tab / overlay stealing foreground interaction.

E2E cases protect correctness while performance changes move work around. Mock-off integration connects through preview-environment routing to the real backend instead of mistaking mock data for preview evidence.

CaseWhat It VerifiesRegression It Prevents
Cold/hot switchStarts from a workstream and records readiness, post-visible blocking, and long taskIdle prewarm or warm-pool changes cannot push loading to after the page becomes visible.
Stress switch20-tab / 5-hot-workstream stress switching plus overlay containmentHot switch cannot rely on unlimited keep-alive; background tabs, cache eviction, and overlays cannot affect foreground.
Preview routingMock-off works; preview routing reaches the workspace backendIf environment is wrong, FMP / tab-switch numbers do not enter the conclusion.
Tab backend contracttab/list/add/remove/pin/unpin/reorder and invalid payloadsReact Query / optimistic mutation optimizations cannot create dirty tab lists, duplicate tabs, or wrong order.
Refresh recoveryRefresh recovers the business URL and per-tab session state shape is validPer-tab URL persistence and cache changes cannot break refresh, sharing, or recovery.
T-BCH-C01, C03Window B syncs through BroadcastChannel after Window A adds or removes a tabMulti-window cannot rely only on local React state.
Subapp open intentsSubapp open requests, legacy navigation, dedupe, invalid payload, origin reject, and bus-v2 behaviorSDK bridge latency, merge, or refactor cannot lose, duplicate, or escalate subapp intent.
T-LFC-C01Focus switch emits TAB_BLURRED before TAB_FOCUSEDBackground tabs must actually enter background; otherwise polling, WebSocket, and prewarm continue stealing CPU.

What changed

This table is not a commit list. It is an index for the rest of the article. Each row follows the same chain: problem, blocker/cause, solution, evidence, and guardrail.

CategoryProblemBlocker / CauseSolutionEvidence / ImpactGuardrail
Measurement contractOld tab switch duration looked fast while users could still see an unclickable page. FMP experiments could also treat lower resource count as a false win.Shell visible and interactive were mixed; local gate, preview FMP, and strict switch had different meanings.FMP uses final first-screen marker; tab switch v3 measures input, visible, interactive, and post-visible blocking; the local stress gate is only a regression gate.Later wins can point to blocker movement or reduced post-visible blocking.Measurement repair itself is not counted as a performance win.
Critical-path reductionCurrent page was not visible yet, but network and CPU were serving future paths.Workstream list, host uploader, AIS, and non-current sandbox entry fanout entered pre-FMP.Keep only current-route first-screen work before FMP; schedule low-priority SDK and non-current runtime work after first-screen ready./workspace/api/workstream/list moved out of pre-FMP on 6/7 root-subapp paths; host uploader 7/7 -> 0/7; sandbox fanout affected routes 5 -> 0.Only defer work that is not part of current first screen; if FMP gets worse, revert.
Route-critical early startReal first-screen route resources were discovered too late.Scheduling chunks appeared at 6785ms-15464ms; Official Forecast CSS appeared at 13789ms-14988ms.Route-aware early discovery for Scheduling chunks and Official Forecast CSS.Scheduling FMP 14773ms -> 11926ms; Official Forecast FMP 14271ms -> 11612ms.Preload only resources proven to block first screen.
Runtime cacheUsers want a tab to be immediately usable after switching back, but not every runtime can stay alive.Cold switch loaded runtime, restored view, and waited for iframe/subapp ready after click.Split opened tabs, hot runtime, and view cache; WarmPool keeps recent working set; IdlePrewarm prepares likely targets after first screen.cold switch p95 1829.8ms -> 812.3ms; post-visible blocking 1193.7ms -> 8.7ms.Hot is not opened. The iframe sandbox is heavier and prewarms more conservatively.
Main-thread schedulingHidden prewarm or SDK init stole foreground main thread during switch.An async import may be safe at check time, but foreground state can change before the bundle finishes loading.Foreground-aware scheduler; re-check before import, after import, before init, before render/open.A1 p95 1700.1ms -> 703.1ms; local stress gate max post-visible long task = 0.Notification/WebSocket/analytics/monitoring are guardrails, not preview FMP wins.
Reject false winsCleaner waterfall or faster shell-visible does not mean users are faster.Resource counts, shell visible, and local memo experiments can produce attractive but wrong numbers.Treat resource movement as a hypothesis; reject if strict profile gets worse.Swimlane chunk average FMP +1217ms reverted; all-hot strict p95 reached 1792.0ms with 517ms post-visible long task.User metric first, causality second; resource shape is only an explanation.

Category 1: First Load / FMP

1. Remove Work That Does Not Belong To The Current First Screen

Problem: while the user waits for the current route’s first screen, network and main-thread time can be spent on future paths or low-priority SDKs. The solution is not a fixed sleep. It is route-specific first-screen readiness: only work that is not part of the current first screen can move after FMP.

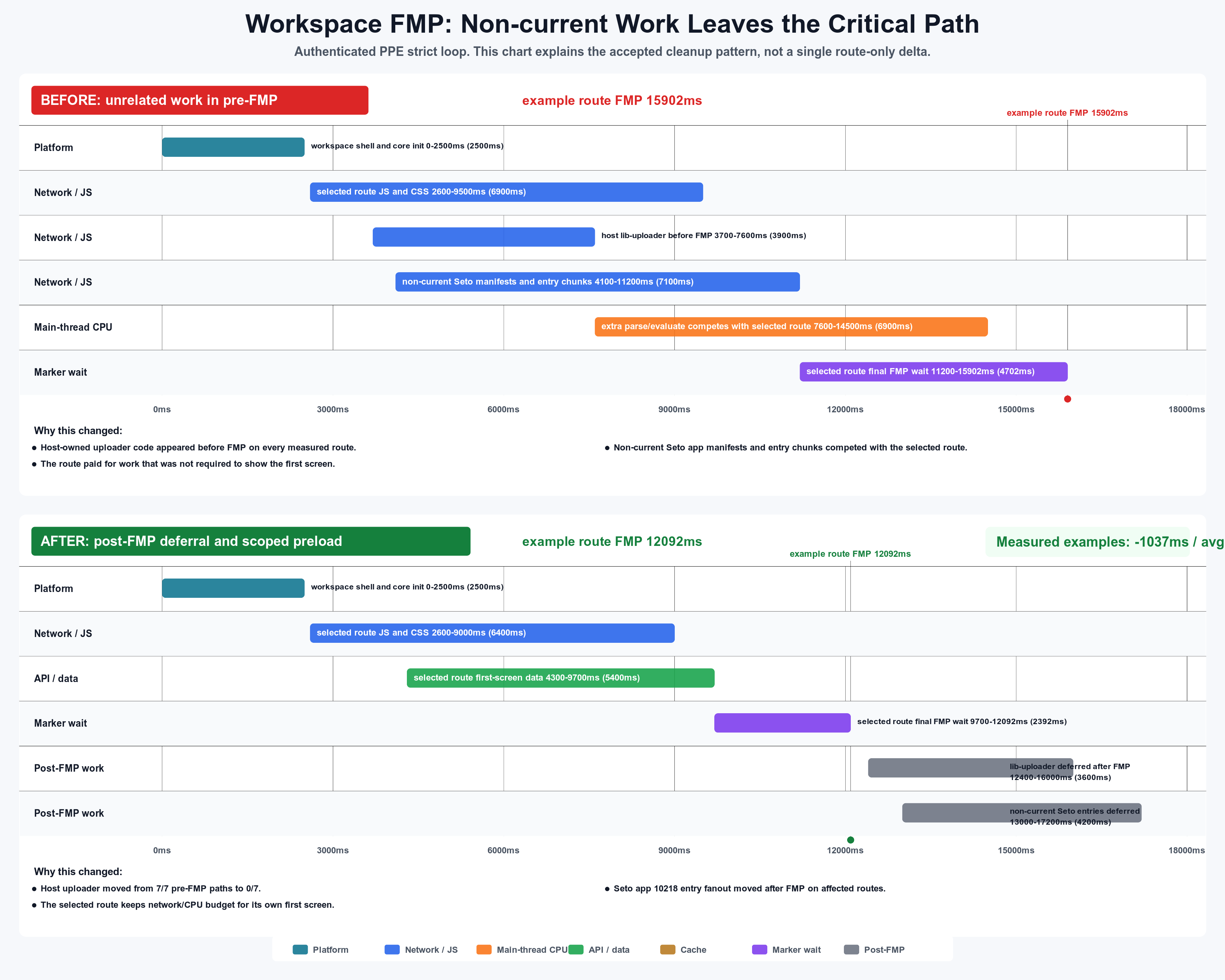

critical path cleanup
Figure P2: Critical-path cleanup waterfall. This is a strict FMP-loop pattern chart. It explains how host uploader moved from 7/7 pre-FMP routes to 0/7, and non-current sandbox entry fanout moved from 5 affected routes to 0. The example route is illustrative; exact route deltas are covered by Scheduling and Official Forecast.
ChangePre-FMP BlockerMovementImpact Scope
Remove pre-FMP /workspace/api/workstream/list refreshRoot-subapp first screen did not need Workstream list, but it entered the waterfall.6/7 root-subapp paths no longer had it pre-FMP.Main run improved on 4/7 paths, average about -1051ms.
Defer AIS / uploaderhost-owned lib-uploader appeared pre-FMP on 7/7 paths.7/7 -> 0/76/7 main paths improved, average about -1037ms.
Defer non-current sandbox entry fanoutSandbox app manifests and static/js/entry.* competed with the current route.affected routes 5 -> 0average about -366ms vs previous accepted run.

Implementation sketch:

// Mounted after route first-screen ready.
// Only schedule work that does not belong to the current first screen.
afterFirstScreenReady(() => {
scheduleLowPrioritySdkInit();
scheduleUploaderInit();
scheduleNonCurrentSandboxPreload();
});

The key is that we defer non-current work, not all work.

2. Scheduling: Route Chunks Moved From Late Discovery To Early Discovery

Problem: Scheduling route chunks were discovered at 6785ms-15464ms, overlapping the final FMP window. The root cause was not simply slow network; the browser learned too late that these chunks were required for the current first screen.

Scheduling FMP moved from 14773ms to 11926ms, a -2847ms / -19.3% improvement.

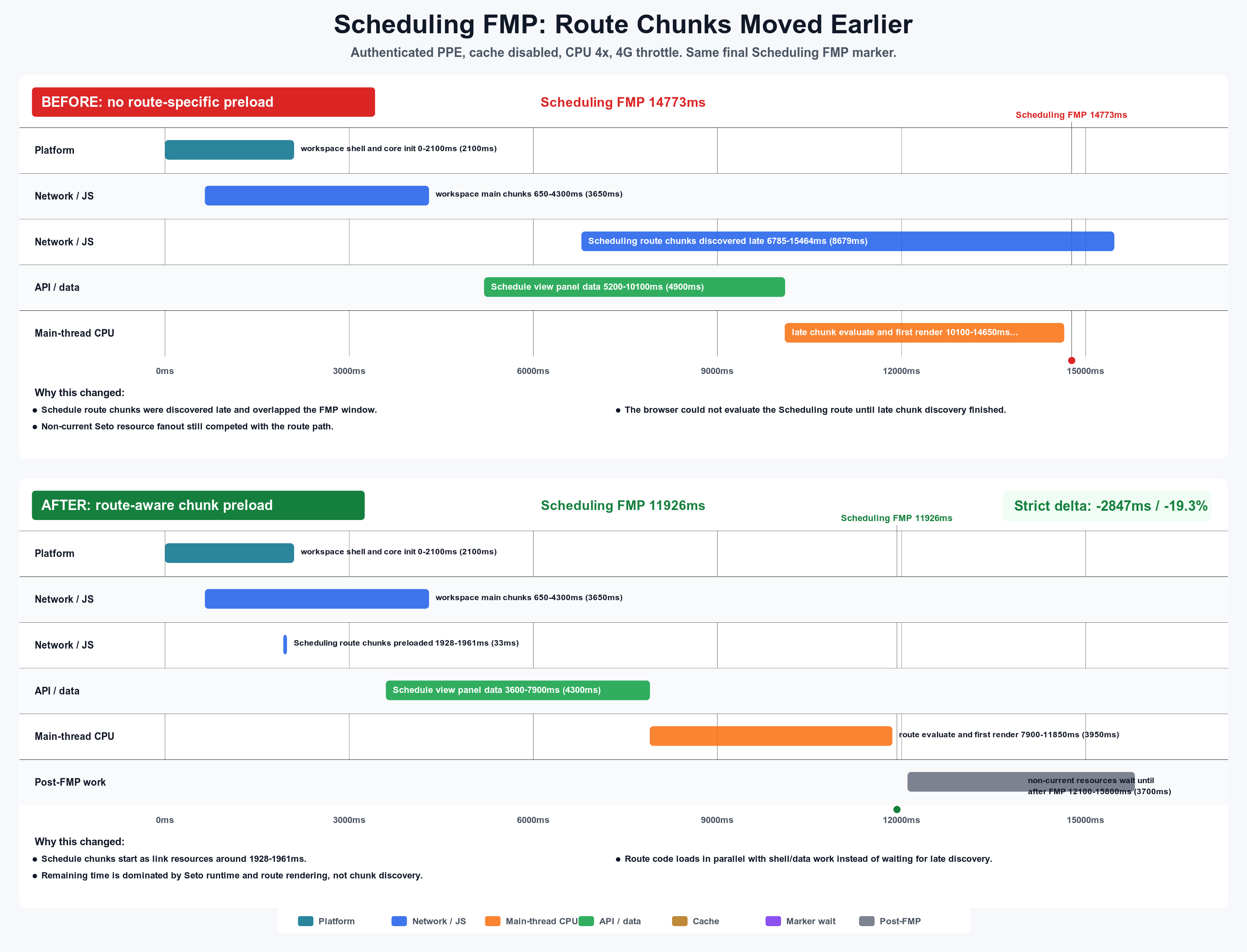

scheduling route chunks
Figure P3: Scheduling route chunks waterfall. Before, route chunks were discovered at 6785ms-15464ms and covered the FMP window. After, matching chunks started as link resources at 1928ms-1961ms.

Code strategy:

// Mounted after route resolver identifies the Scheduling route.
// Preload only chunks needed by this first screen, not the whole route family.
if (currentRouteMatches('/scheduling/schedule')) {
preloadRouteChunks([
'schedule route chunk',
'schedule view panel chunk',
]);
// This still waits for core data; do not prefetch dependent data too early.
prefetchScheduleViewPanelAfterCoreData();
}

Why it works:

  • route chunks and first-screen data do not have to be fully serial;
  • early route chunk discovery lets code loading run in parallel with shell/data;
  • the remaining FMP window is sandbox runtime, data, and render, not late code discovery.

3. Official Forecast: Route-Critical CSS Cannot Wait Until The End

Problem: Official Forecast CSS appeared at 13789ms-14988ms, so the final marker waited for late stylesheet discovery. The solution is not “preload everything”; it is only to start the stylesheet that stabilizes the first screen.

Official Forecast FMP moved from 14271ms to 11612ms, a -2659ms / -18.6% improvement.

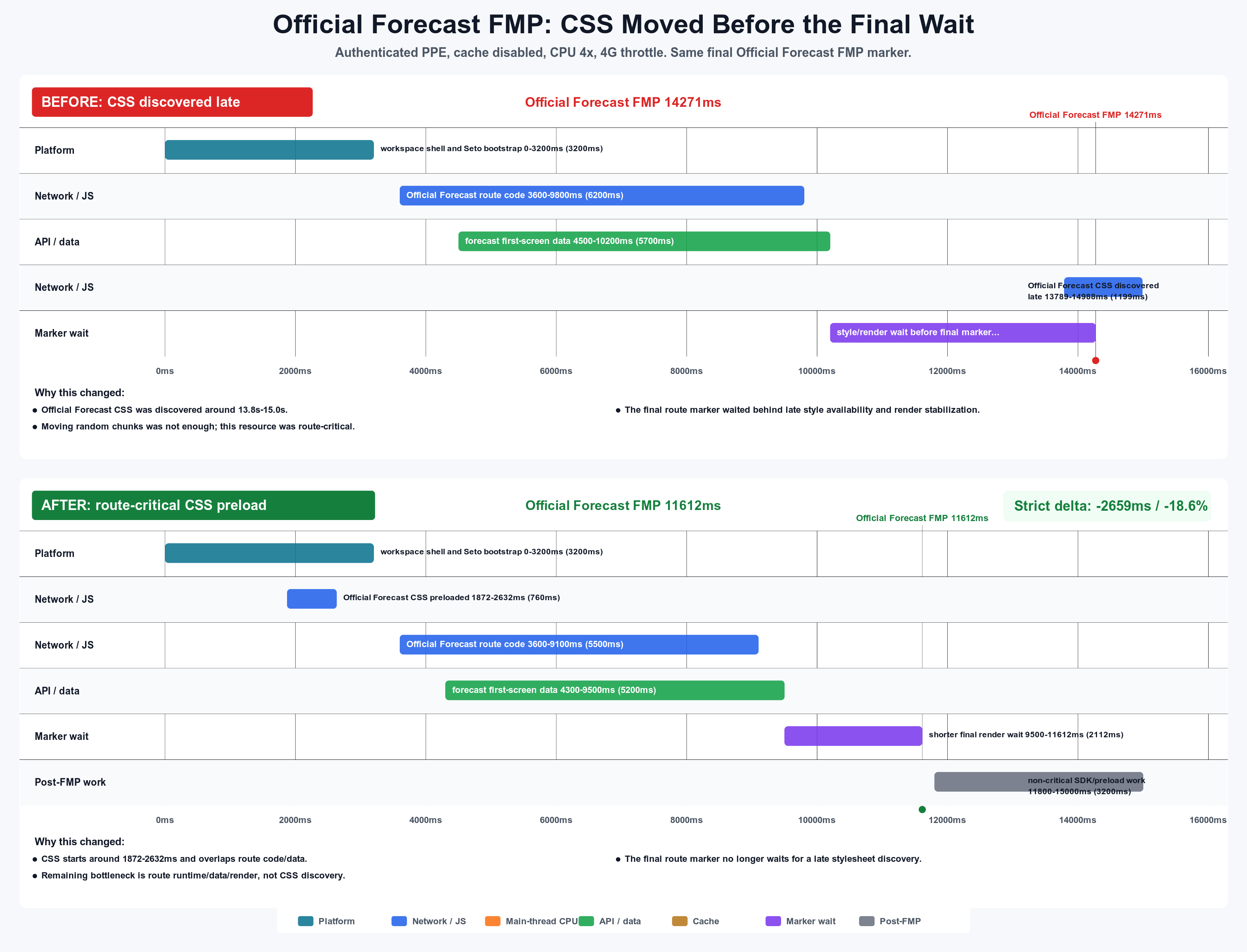

official forecast css
Figure P4: Official Forecast CSS waterfall. Before, CSS appeared at 13789ms-14988ms. After, CSS started at 1872ms-2632ms and ran in parallel with route code/data.

Code strategy:

// Only when Official Forecast route matches.
// This CSS affects first-screen stability, so it is route-critical.
if (currentRouteMatches('/scheduling/official_forecast')) {
preloadStylesheet('official forecast critical css');
}

Why it works:

  • this is not generic “add more preload”;
  • the CSS directly affects final first-screen stability;
  • moving it away from the final wait window removes a late FMP blocker.

4. Counterexample: Swimlane Chunk Was Not A Win

One experiment moved the Swimlane chunk out of pre-FMP. The waterfall looked cleaner: pre-FMP count 7/7 -> 0/7. Strict runs showed average FMP got worse by +1217ms, and load-start also regressed, so the change was reverted.

This counterexample matters because performance optimization is not waterfall beautification. Fewer resources with slower users is a failure.

Category 2: Hot Tab Switch

The hot-switch target is not “the frame appears.” It is “the user can operate after seeing the frame.” That is why v3 measures post-visible blocking.

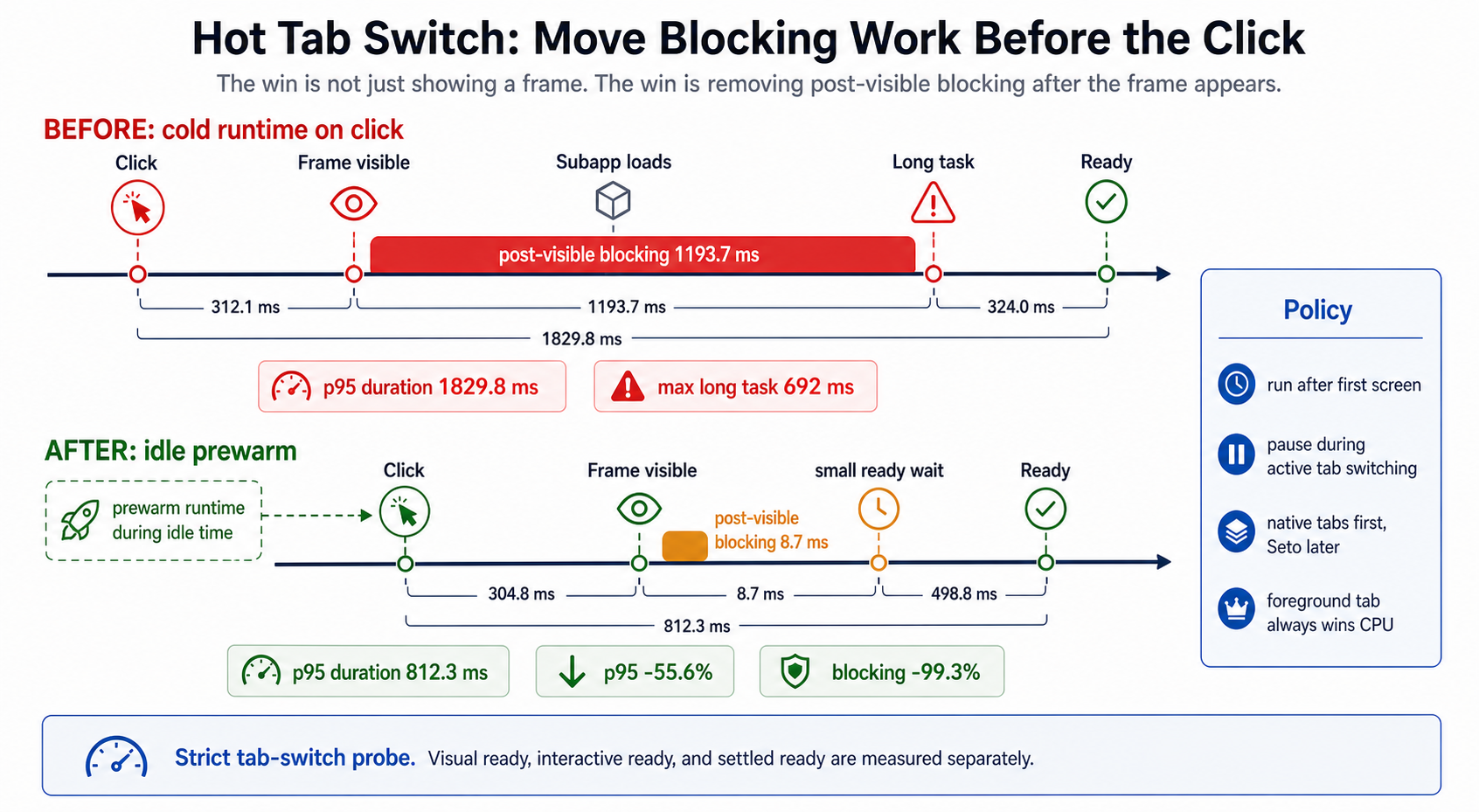

hot tab switch causality
Figure P5: Hot tab switch causality. Before, the cold runtime loaded after click, and the frame still had 1193.7ms blocking after becoming visible. After, idle prewarm moved the main preparation work before click, reducing post-visible blocking to 8.7ms.

1. Idle Prewarm

Problem: cold switch loaded runtime, restored view, and waited for iframe/subapp ready after the user clicked. The frame could appear first, but long tasks still blocked interaction. The solution is to prepare likely return targets during idle windows after first screen.

MetricBeforeAfterDelta
cold switch p95 duration1829.8ms812.3ms-55.6%
visibleToReady p951693.7ms508.7ms-70.0%
postVisibleBlocking p951193.7ms8.7ms-99.3%
max post-visible long task692ms73mssignificantly lower

Implementation sketch:

// Mounted after first-screen ready.
// Native runtime is lighter, so it can enter the queue earlier.
// The iframe sandbox is heavier and needs a more conservative delay.
afterFirstScreenReady(() => {
queuePrewarm(nativeTabs, { delay: 1000 });
queuePrewarm(sandboxTabs, { delay: 3000, primeLifecycle: true });
});

Why it works:

  • part of runtime loading, initialization, and lifecycle priming happens before click;
  • click no longer puts large subapp loading and long tasks after visibility;
  • prewarm only runs after first screen, so it does not steal FMP budget.

2. Runtime-Aware Prewarm

The tradeoff is explicit: prewarming every runtime immediately is simple, but the iframe sandbox is heavier and can turn a background optimization into foreground pressure. The final policy warms native runtimes earlier and sandbox runtimes more carefully.

Scenariop95 durationvisibleToReadypostVisibleBlocking
immediate cold baseline1853.8ms1657.7ms1157.7ms
runtime-aware early switch1285.3ms1029.8ms529.8ms
delta-30.7%-37.9%-54.2%

Warm pool and idle prewarm must consider runtime type, foreground pressure, and whether a switch is settling. “Preload earlier” is not automatically good.

3. Pause Hidden Prewarm To Remove Foreground Spikes

Problem: while the user switched to Supervisor, hidden/background Audit Workbench, xlsx, monitoring, and related work competed on the main thread. The solution is a foreground lease: while the foreground tab is switching or not settled, background tasks must yield.

// Every hidden prewarm and background SDK task checks before running.
// Async import must re-check after loading because foreground state can change.
function shouldRunBackgroundTask(tabId) {
if (foregroundTabHasLease() && tabId !== focusedTabId) return false;
if (tabSwitchIsSettling()) return false;
return true;
}

Impact:

MetricSpike BeforeAfterDelta
p95 duration1700.1ms703.1ms-58.6%
shell visible1199ms194ms-83.8%
interactive1250ms194ms-84.5%

This proves the scheduling rule: prewarm that steals from the current tab is a negative optimization.

Category 3: Background Pressure

Problem: hidden tabs can still be alive, and SDKs such as Notification, WebSocket, analytics, monitoring, visit, storage health, and AIS can create future tab-switch long tasks if they run like a normal single-page app. The solution is a foreground-aware scheduler.

// Background work cannot run directly. It goes through one arbiter.
function scheduleWorkspaceBackgroundTask(task, options) {
requestIdleCallback(() => {
if (shouldDeferWorkspaceBackgroundTask(options.tabId)) {
retryLater();
return;
}
task();
});
}

Async tasks must re-check around import / loader:

async function safeLoadSdk() {
if (shouldDefer()) return retryLater();
const sdk = await importSdk();
// Import can take hundreds of milliseconds.
// By the time it returns, the foreground tab may be switching.
if (shouldDefer()) return retryLater();
sdk.init();
}
Background TaskChangeEvidence Scope
MF preloadRe-check foreground state before and after getEntries.Local stress gate: p95 visual about 31.2ms, postVisibleBlocking about 7.8ms, max long task = 0.
Notification SDKNotification bundle about 657.2KB gzip; re-check before/after import/open/render.Local stress gate: postVisibleBlocking about 7.1ms, max long task = 0.
WebSocketImport, init, and register enter scheduler.Local stress gate: visual 42.1ms -> 36.6ms, about -13.1%.
AnalyticsFlush queue in slices and yield to foreground.Local stress gate: visual 31.5ms -> 29.5ms, about -6.3%.
Monitoring / visit / storage health / AISafter first screen, idle, foreground-aware.Guardrail; not claimed as preview-environment main win.

These changes keep future SDK work from becoming a tab-switch jank source. They are stability work, not FMP wins dressed up as something bigger.

Rejected optimizations

ExperimentWhy It Looked ReasonableWhy It Was Rejected
Move Swimlane chunk out of pre-FMPCleaner waterfall and lower pre-FMP countAverage FMP regressed by +1217ms; user metric got worse; reverted.
Full optimistic focus / all-hot activationFrame could theoretically become visible fasterstrict p95 reached 1792.0ms and produced 517ms post-visible long task; reverted.
Broad sandbox prewarm / hidden layout-visibleHoped to finish sandbox work earlierEasy to steal foreground CPU; unstable benefit; not used as the main policy.
Small component memo / local cache experimentsLooked like they would reduce renderLocal p95 got worse or strict benefit was missing; not kept.
Old tab switch duration onlyCould produce numbers in tens of millisecondsMissed input queue and post-visible blocking; metric itself was not trustworthy.

Reusable method

  1. Split by path first. FMP, tab switch, and background pressure are different problems and need different measurements.
  2. Assign resource ownership. Current first-screen resources move earlier; non-current first-screen work moves later; future resources can only run through idle prewarm.
  3. Draw causality before writing the conclusion. The chart must show the blocker moving, disappearing, shrinking, or moving after FMP.
  4. Accept failures. If a resource moves but FMP gets worse, revert it.
  5. Keep local gates and preview wins separate. The local stress gate is a regression gate, not an online/preview win.

The wins did not come from one clever trick. Three boring rules did most of the work:

  • the first-screen critical path keeps only current-route required work;
  • hot switching uses bounded runtime cache plus idle prewarm;
  • background work yields to the foreground scheduler.

That matters more than any single patch. Workspace will keep adding subapps, SDKs, and runtimes. Without path classification and resource arbitration, every new tab feature would make performance harder to predict.
